Public Private Partnerships (PPP or P3) is an umbrella term for many forms of private-sector involvement in the provision of traditional public-sector services. A PPP is a set of contractual arrangements between a public agency and a private-sector entity structured to meet the need of the public by:
PPPs can be applied to a variety of infrastructure:
Spanning the range of private sector control and responsibility, from technical assistance and management contracts to privatizations, P3s should be designed and structured for the public need, including the influencing factors of the political and economic landscape.

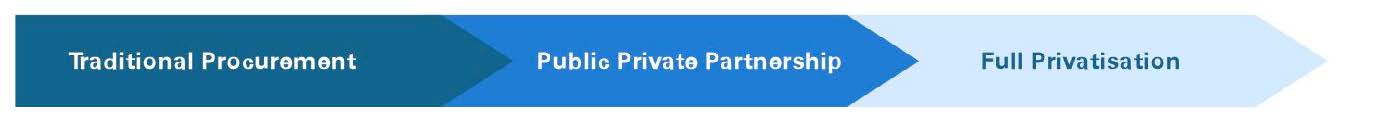

There is a range of private sector participation in public infrastructure
The procurement of assets by the public sector using conventional lowest price and government funding
Design, bid, build, finance (DBB or DBF)
There are many PPP structures but a typical one has the following characteristics:

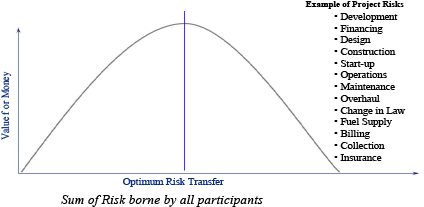

Under PPP contracts, risks are allocated through contractual structures to those parties that are best able to manage the risks. This means that only those risks are transferred to the private sector which the private sector is able to manage. Similarly, the public sector will retain those risks that it is best placed to manage. For some risks it may be appropriate for the public and private sectors to share the risk. Undertaking this risk-allocation process to arrive at an optimum risk transfer to the private sector means that VFM can be maximized.

This is what is supposed to happen…

This is what actually happens…

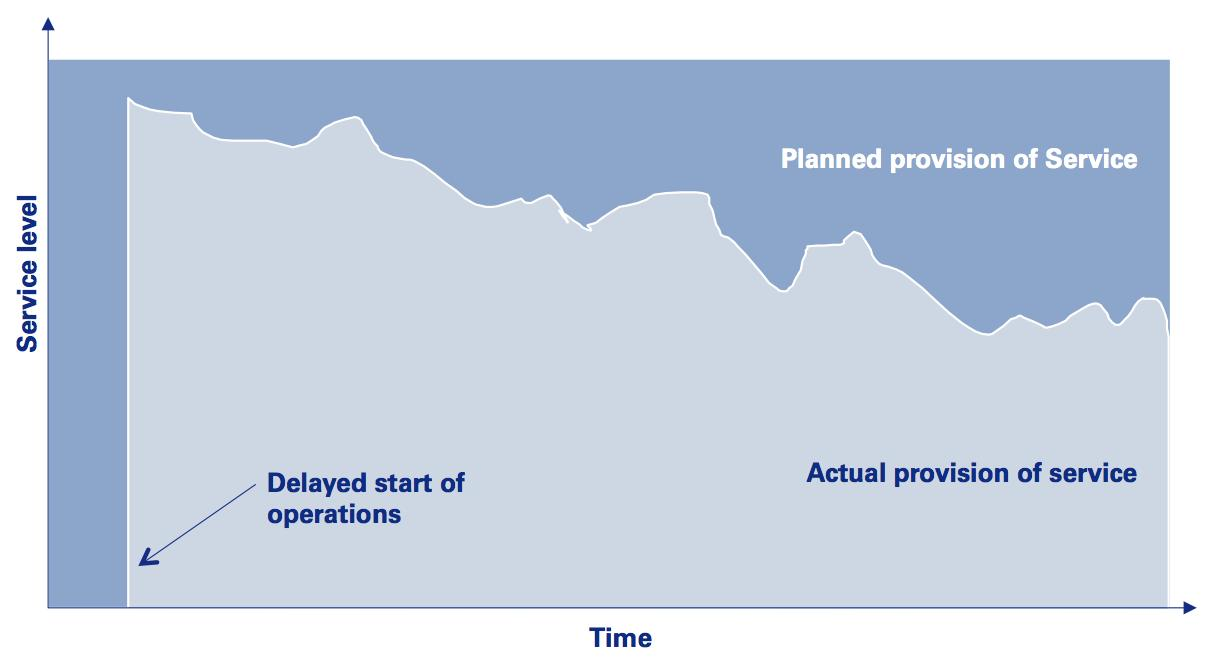

… and this is what the service level looks like - poor value for money

The main benefits of PPP arise from the improved management of risks transferred to the private sector. The involvement of senior lenders should ensure that all risks are identified, mitigated and managed, resulting in a comparatively mature project before contract signature:
A December 2007 study of 21 PPPs and 33 traditional projects in Australia found that traditional projects experienced significant cost overruns and schedule delays while PPPs were generally delivered on time and on budget. These overruns are relative to the price and timetable agreed to at the time of contract signature.
The study revealed that on a contracted A$4.9 billion of PPP projects, net cost overrun was only A$58 million (a 1.2% overrun). For A$ 4.5 billion of traditional procurement projects, net cost overrun amounted to A$ 673 million (a 15% overrun).
The study also showed that 23.5% of traditionally-procured projects were delivered late and no PPP procured projects were delivered late. In fact, 3.4% of the PPP projects were actually delivered ahead of schedule.
In October 2009 the UK National Audit Office issued a report which supported the overall conclusions of the Australian study: PPPs are much more likely to be on time and on budget. The UK study consisted of 114 PPP projects and 400 traditionally-procured projects.
Of the 35% of the projects in the UK study that experienced cost overruns, only 14.3% of these projects had cost overruns of 5% or more. That is, nearly 95% of PPP projects were delivered “on or close to budget”.
The HM Treasury in the UK estimates that road and prison projects undertaken through PPP have delivered average savings of 17% compared to what the costs would have been had the projects been undertaken through traditional procurement.
Value for Money is achieved when the required quality of service is delivered at a cost that is cheaper than the cost of conventional public-sector delivery of the same services and at a quality level equal to or better than if provided by the public sector.
A PPP contract transfers many of the risks of ownership of the project to the private sector, which puts its capital behind the successful delivery of the facilities and service.
The payment structure (or tariff mechanism) is the principal means of defining the risk allocation within the project.
Bids should be compared for:
- Value
- Contractors’ ability to accept risk
- Benefits compared to a conventional solution
- Innovation
- Suitability as a long-term supply partner
The public-sector partner should concentrate on stipulating the required service outputs, allowing the PPP Contractor as much latitude as possible as to how these output requirements are met.

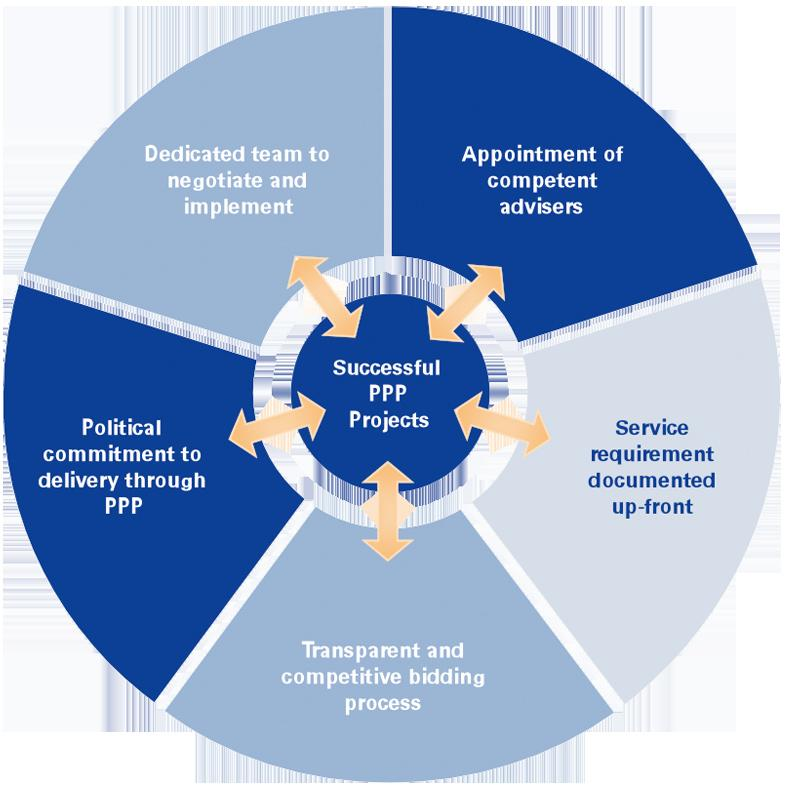

To take advantage of the potential benefits of PPP, the public sector needs to recognize the need for the above success factors to be in place.
This will help to ensure that PPP will deliver the expected Value for Money.
